Nambiar Beverly Park Construction Status
Nambiar Beverly Park construction status: there is no construction. The project is pre-launch. What exists today is design and documentation — a master plan drawn across 76 acres, a Phase 1 layout defining 298 villa plots on 36 acres, and the villa designs behind them. K-RERA registration has been applied for and approval is expected by 20 August 2026, but until it is granted, no work on the ground can be reported as a registered milestone.
We are deliberate about this page because it is the one most often padded. There is no groundwork, no excavation, no levelling, no roads laid and no percentage of completion to quote, and we will not publish a site photograph before registration. What follows is the project stage as we can actually evidence it, and what we will add here as each milestone is genuinely reached.
Where the Project Stands Today
| Stage | Status |
| Master plan | Drawn — 76 acres for the full development |
| Phase 1 layout | Defined — 36 acres, 298 villa plots |
| Villa designs | Defined — G+2, two principal footprints, east and west facing |
| K-RERA registration | Not yet issued |
| Launch | Not announced |
| Work on site | None reported to us |
| Completion timeline | Not announced |
What Has Been Defined

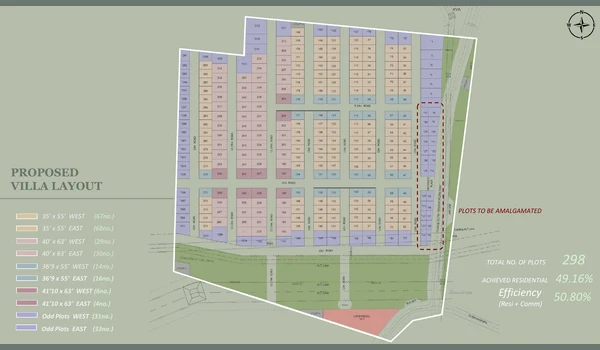

The master plan is the one document that gives the project a shape today. It organises the full 76 acres, of which Phase 1 takes 36 acres and carries 298 villa plots. Within Phase 1 the mix runs to 135 plots at 35 × 55, 59 at 40 × 63, 30 at 36'9" × 55, 10 at 41'10" × 63 and 64 odd plots, split east and west facing. Land use is planned at 49.16% residential, or 50.80% counting the commercial block at the gate.
The layout also fixes the circulation and the green edge: six landscaped parks along the southern boundary, 12 m and 12.19 m internal roads with 9.14 m secondary roads, an entrance plaza with a dedicated bus bay, a retail and commercial block at the gate, and a 220 kV HT line realigned along the southern boundary. Setbacks follow the Karnataka Gazette Part-IVA, Table 8 schedule for plots of 150–250 sq.m — 1.0 m front, 0.8 m rear and 0.8 m at the sides.
Each villa is designed as G+2 with a private lift serving all three levels: living, dining, kitchen and one bedroom on the ground floor; three bedrooms on the first around a double-height void; and the second floor given to terrace — a multipurpose room, a celebration terrace, a wellness terrace, a yoga deck, a dance deck and a barbeque zone. Covered parking for two cars, a driver's toilet, a separate domestic-help room with bath and a utility complete the plan. A 35 × 55 plot of 1,925 sq.ft. carries a villa of 3,732 to 3,782 sq.ft.; a 40 × 63 plot of 2,520 sq.ft. carries 4,627 to 4,638 sq.ft.
What Has Not Happened Yet
Stating this plainly is more useful to you than a progress bar:
- K-RERA registration has been applied for; approval is expected by 20 August 2026, and no registration number has been allotted. Verify that yourself at rera.karnataka.gov.in.
- The project has not launched. The developer's stated launch date is 20 August 2026, and it falls after the expected K-RERA approval rather than before it — registration first, launch second. Completion is stated for 31 December 2030 and the developer's stated possession date is 15 January 2031. Those are the developer's stated dates; none of them is a commitment until it is declared in the registration, and we do not treat them as milestones achieved.
- No sanctioned-plan or clearance references have been shown to us, so we make no claim that any approval is in place.
- No site works have been reported to us — no clearing, levelling, roads, drainage or utilities.
- No sales office or model villa is open, and we quote no visiting hours for one.
- Prices and charges are indicative and subject to change until they are registered.
How This Page Will Be Updated
We will add a milestone here only when it can be evidenced, and we will say what the evidence is. In the order we expect them:
- K-RERA registration granted — we publish the registration number and link the portal listing, and the registered areas and dates replace the indicative ones across this website.
- Launch announced — the launch name, the released inventory and the price list as registered.
- Quarterly progress filings — once a project is registered, the promoter files progress with K-RERA every quarter and those filings are public. We will link them rather than paraphrase them.
- Site works — recorded here as the filings record them, in the promoter's own terms, without embellishment.
- Photography — site photographs will appear only after registration. Until then this page carries master-plan artwork and renders only.
Those entries will be posted to the Nambiar Beverly Park update log, which carries the current stage and the source each future update will be drawn from. It has no dated entries yet, for the reasons above.
What You Can Do at This Stage
- Register your interest. Expressions of interest are being taken now, from ₹5 lakh. An expression of interest puts you on the list to be told when registration is granted and the launch particulars are published. It is not an allotment and reserves nothing, and it is fully refundable if you choose not to proceed at any point before you sign a formal agreement.
- Check K-RERA yourself. Search the project name and the promoter name Nambiar Builders at rera.karnataka.gov.in. If nothing is returned, the project is not registered.
- Read the layout and the villa plans and compare them against the registered documents when those are published.
- Do not commit money before registration. Under the Real Estate (Regulation and Development) Act, 2016 a project may not be advertised, marketed or sold until it is registered.
Frequently Asked Questions about Construction Status
1. Has construction started at Nambiar Beverly Park?
No. The project is pre-launch and no construction has begun. The master plan is drawn and the Phase 1 layout of 298 villa plots across 36 acres is defined, but nothing has been built and no site works have been reported to us.
2. Why is there no percentage of completion on this page?
Because there is nothing to measure yet. A completion percentage is meaningful only against a registered scope and a registered timeline, and this project has neither. Quoting one now would be an invention.
3. Where can I independently verify the project's progress?
The Karnataka RERA portal at rera.karnataka.gov.in is the authoritative source. Once a project is registered the promoter must file quarterly progress reports there, publicly viewable, so you can check any claim on a channel-partner site against them. Today the project is not listed.
4. When will the villas be ready?
The developer's stated completion date is 31 December 2030 and the stated possession date is 15 January 2031. Read both as stated dates rather than commitments: a handover date becomes enforceable only when recorded in the K-RERA registration, which has been applied for.
5. Can I visit the site or a model villa?
There is no sales office and no model villa open at this stage, and there is nothing built on site to view. Register your interest through the contact page and we will tell you when the developer opens the project for visits.
6. Why are there no site photographs here?
A pre-registration project should not be marketed with site imagery, and a photograph of undeveloped land tells you nothing reliable about what will be built. This page carries master-plan artwork instead; photographs follow once there is genuine work to show.
